This article describes the activities required to install the long awaited heated driveway.
All Photos of the Project
Background
When I built the house, I also intended to install a heated driveway, however since some of the areas were backfilled with new material (i.e. the stairs/landing to the front door, etc.), it was decided to wait for the ground to settle before installing. However, we then got delayed by the sale of the neighbours house and the COVID pandemic. The neighbours house is stalled, but it is finally time to have the driveway completed.
The Current State of the Driveway:

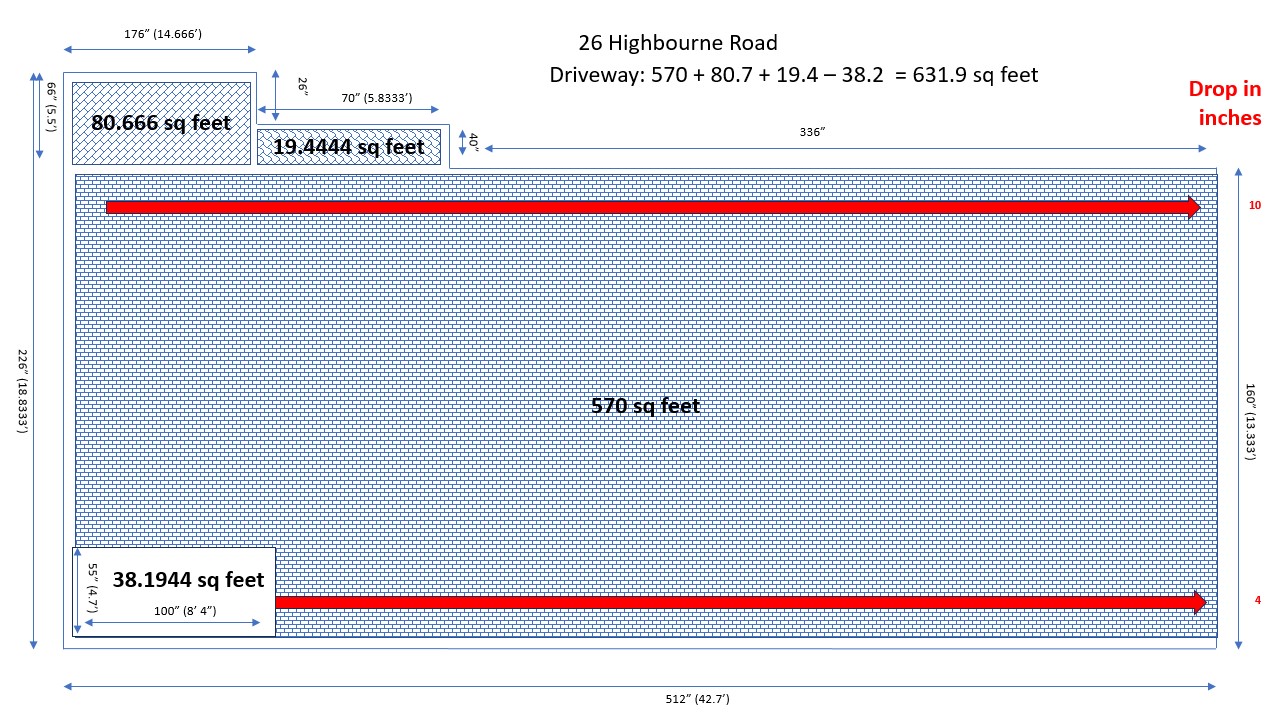

The driveway was left as crushed limestone (basically screening). The main portion of the driveway is approximately 640 square feet with a 4" drop on the high side and a 10" drop on the lower side.

Design
The design is to include 5 heating loops (using a 6 loop 3/4" PVC header - which will leave us with a spare loop) using 3/4" Glycol PVC loops to heat the area. 4 Loops are designed in for the main driveway space (640 sq feet) and a single loop under the front steps and landing leading to the front door which is a shorter loop of approximately 50 square feet. So in total about 700 square feet of heated areas. This will require about 1,000 feet of 3/4" PVC pipe.
After debating the cheaper option to use patterned concrete (in one pour) versus the more expensive 80 mil pavers with a concrete base, and taking into consideration the fact that we are late in the season and will have to use the more expensive 'winter concrete', the final decision was made to use the pavers.
Project Updates

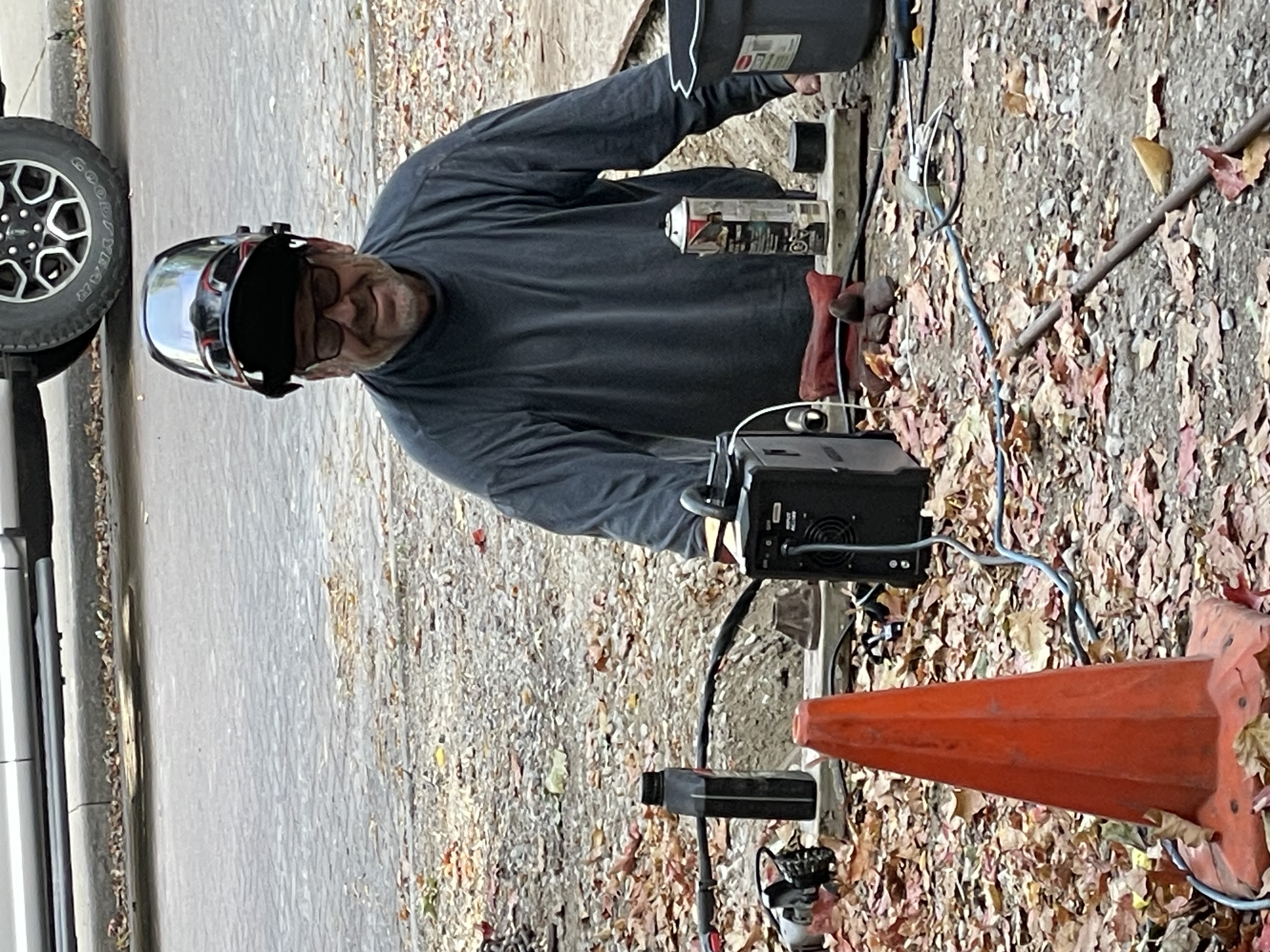

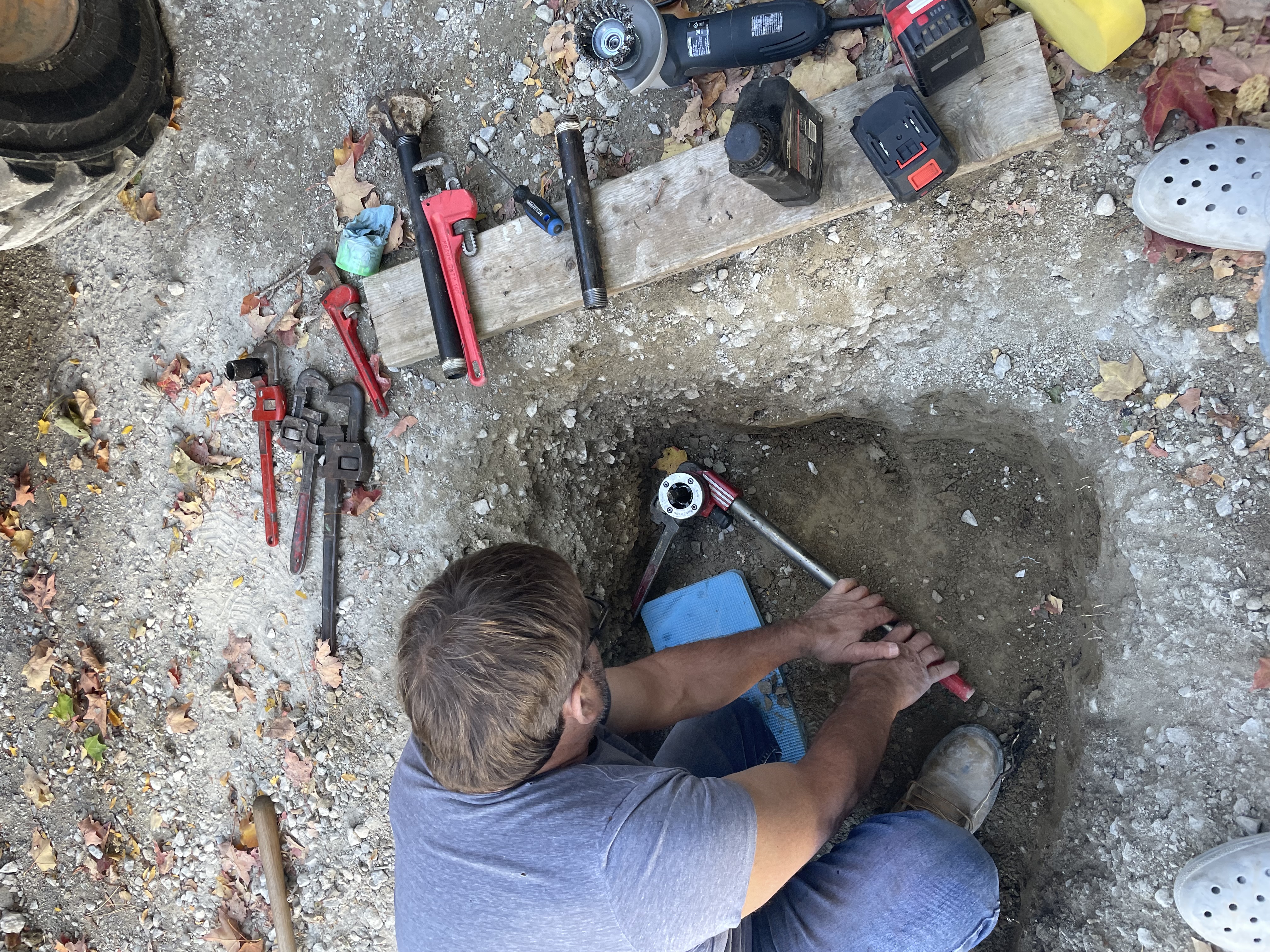

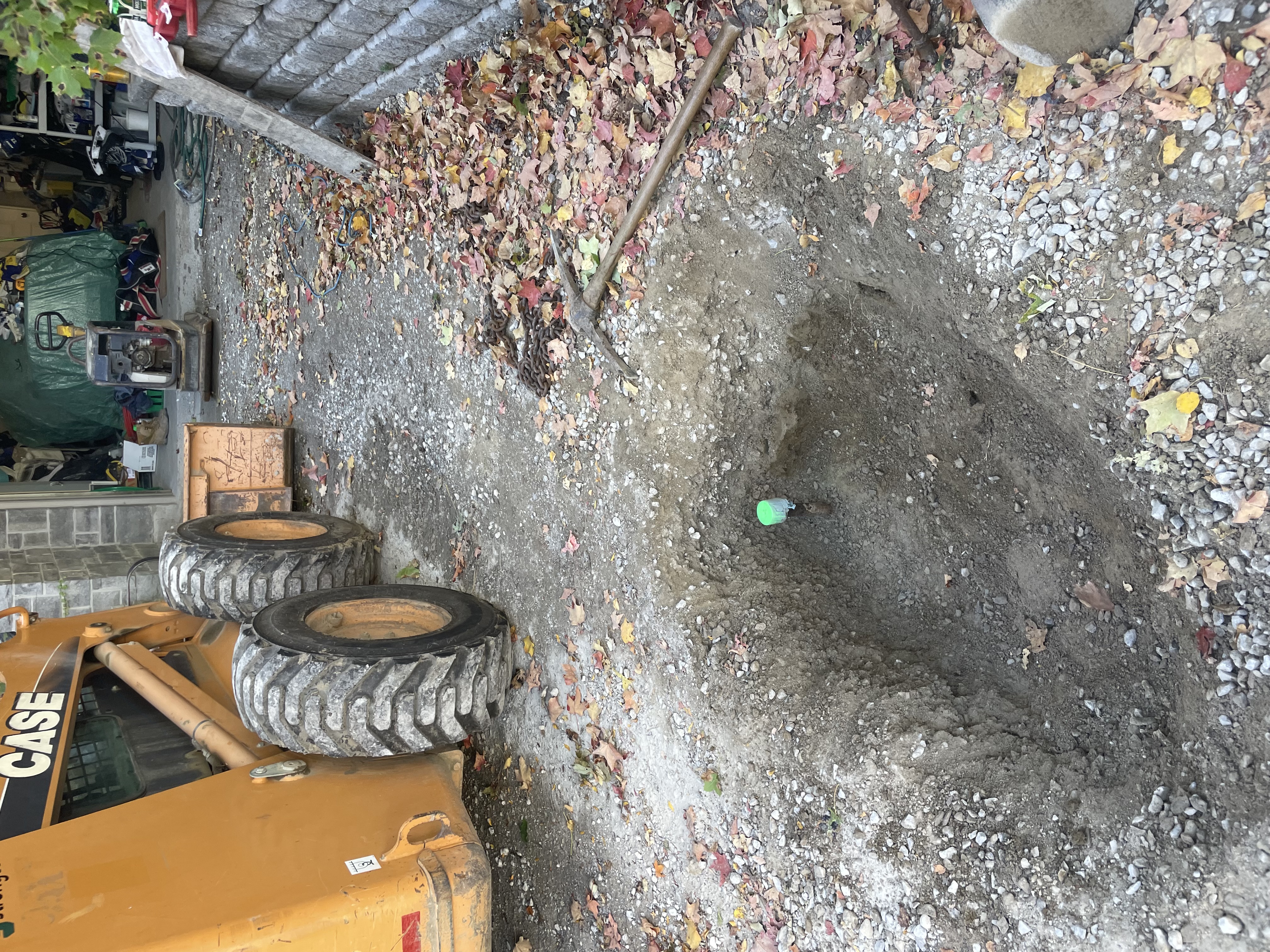

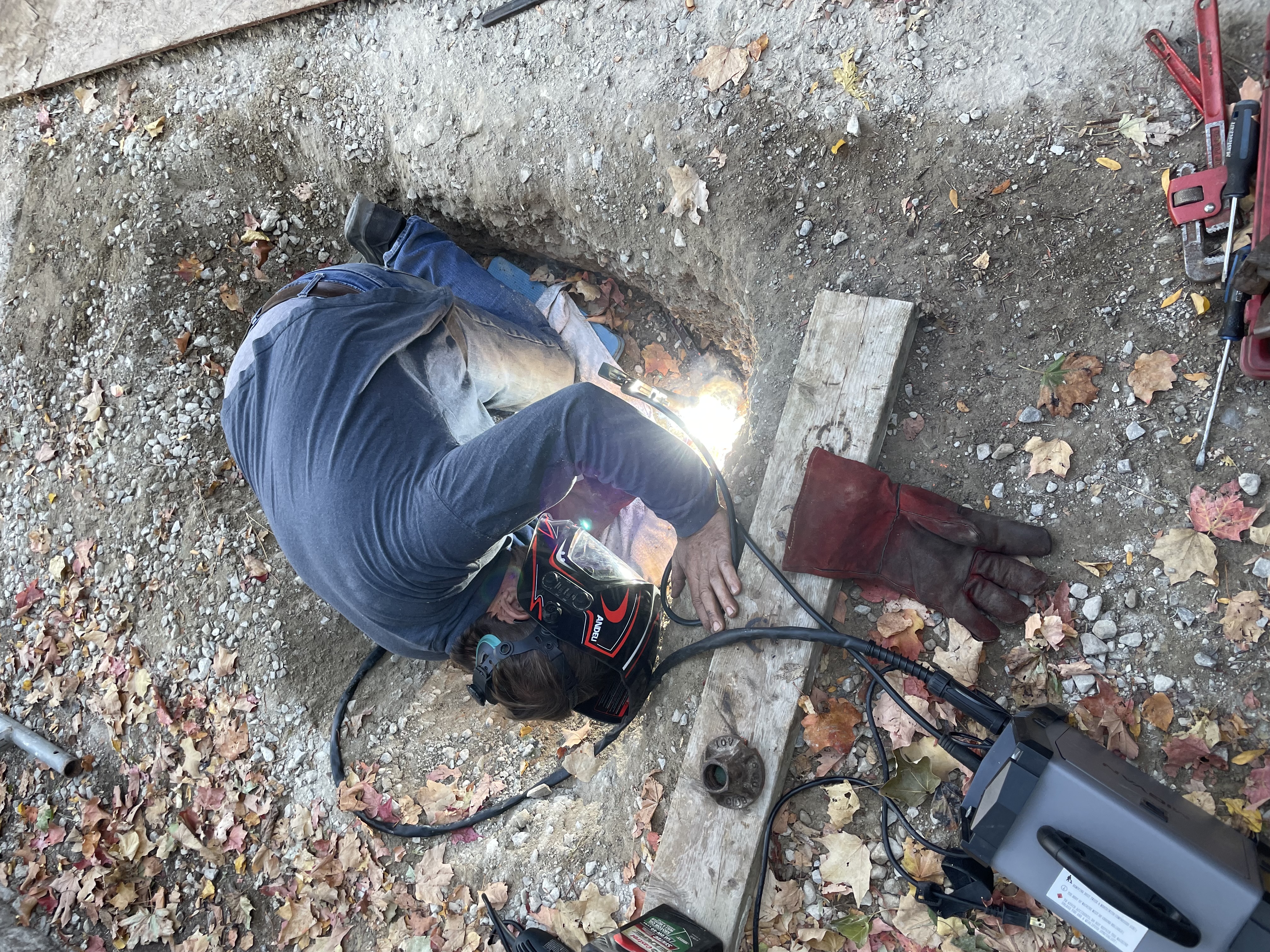

Even before we started work, a repair is required to the Water Box valve in the middle of the driveway. The repair is needed to repair a slightly bent and corroded pipe. A simple coupling, pipe extension, threading and welding is what is needed to do the fix.
Water Box Repair

With the Water Box repaired, it is time to focus on getting the orders in for the driveway materials.
Driveway Materials

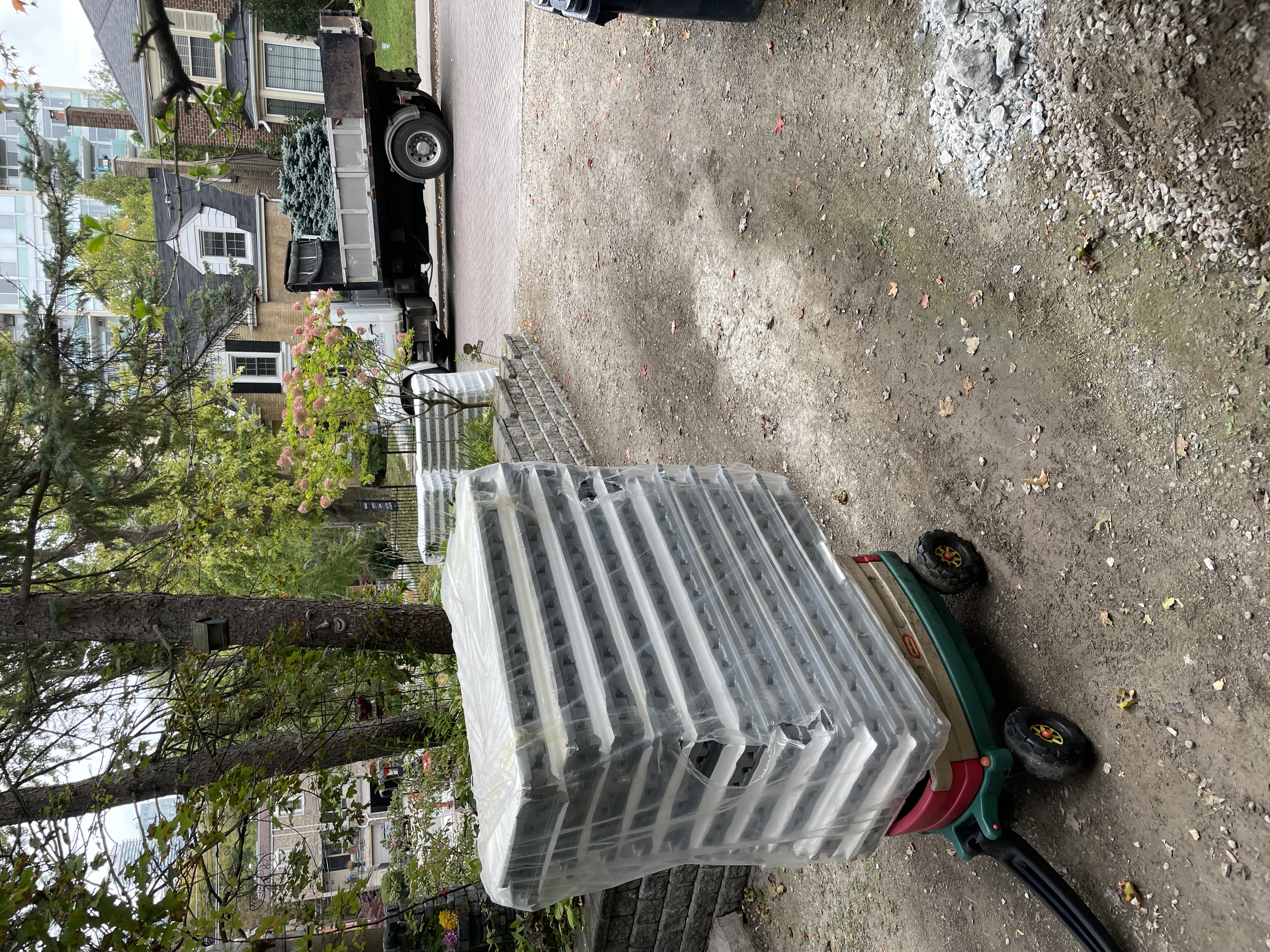

Pucks

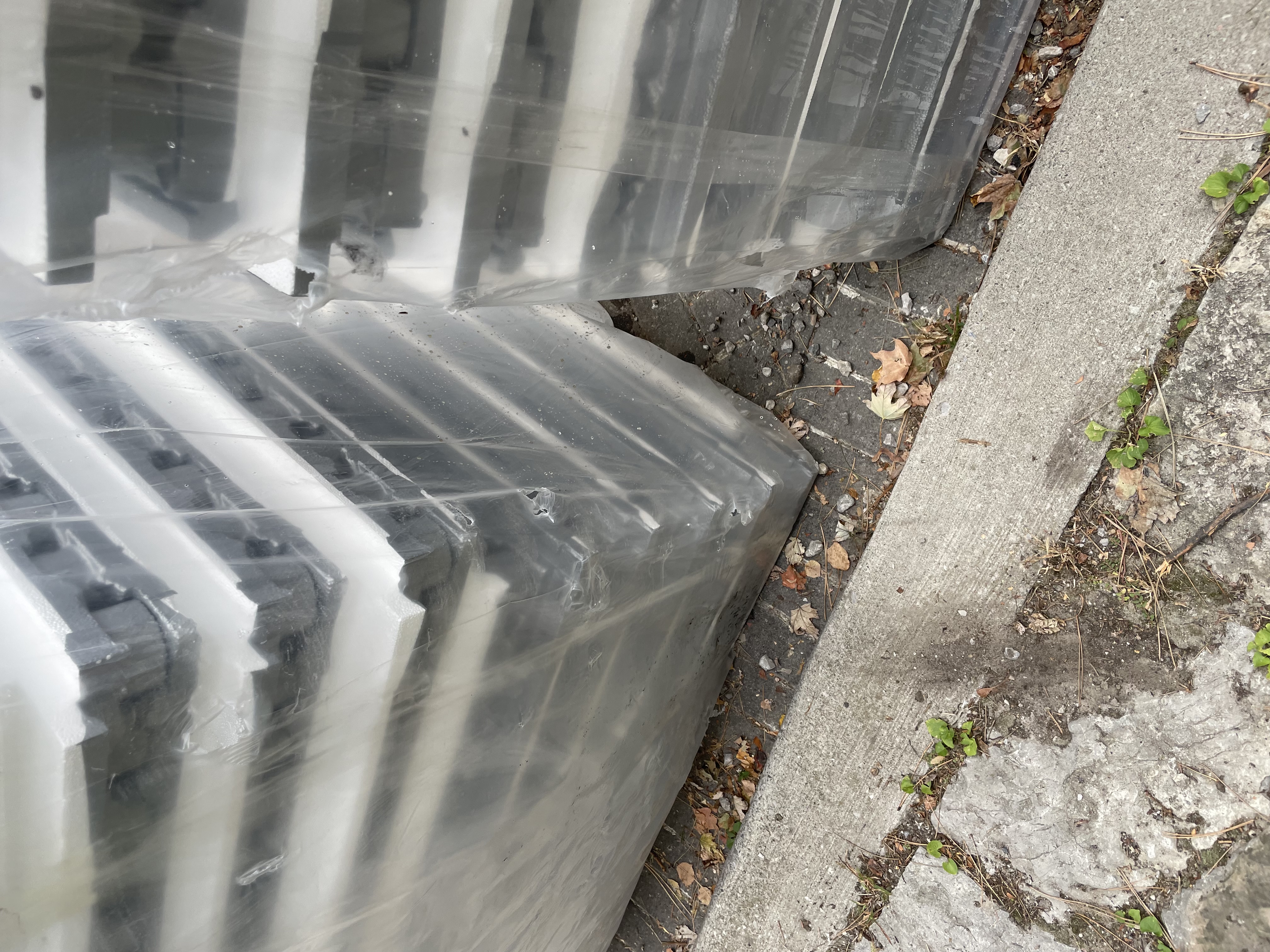

We are using the styrofoam "Pucks" system to insulate and manage the PVC pipes.

Pavers
Ordered the Trevista 80mil pavers sold in 3 sizes to be placed in a pattern to match the house ‘stone work’.

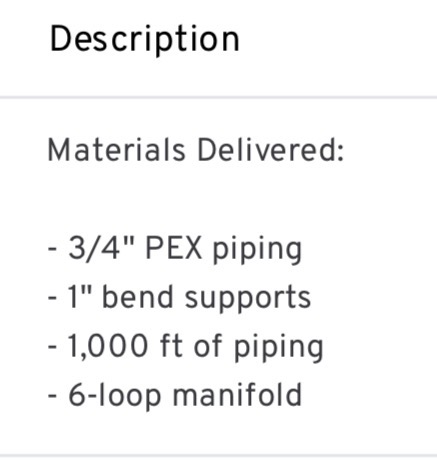

Header and Pipe

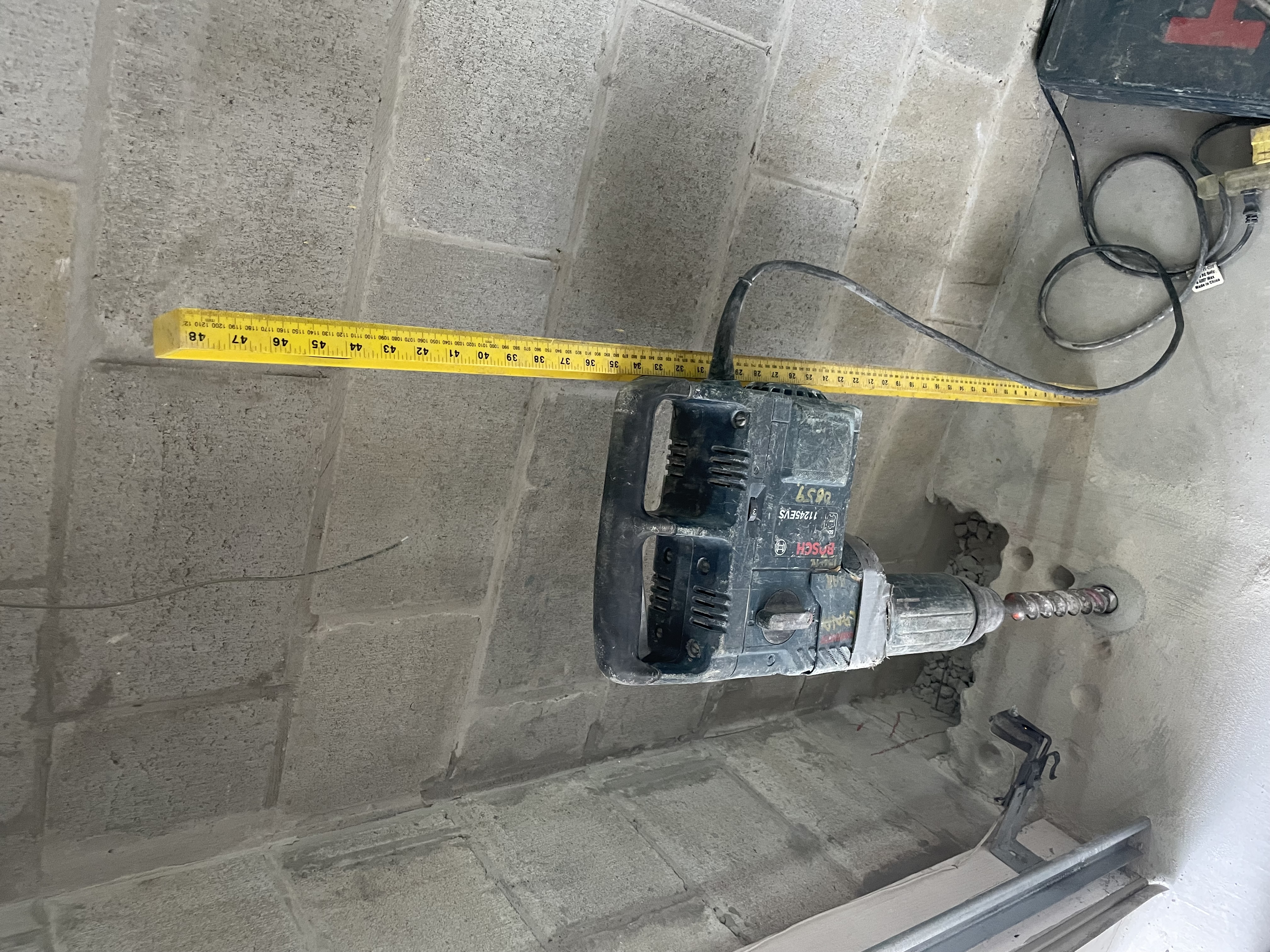

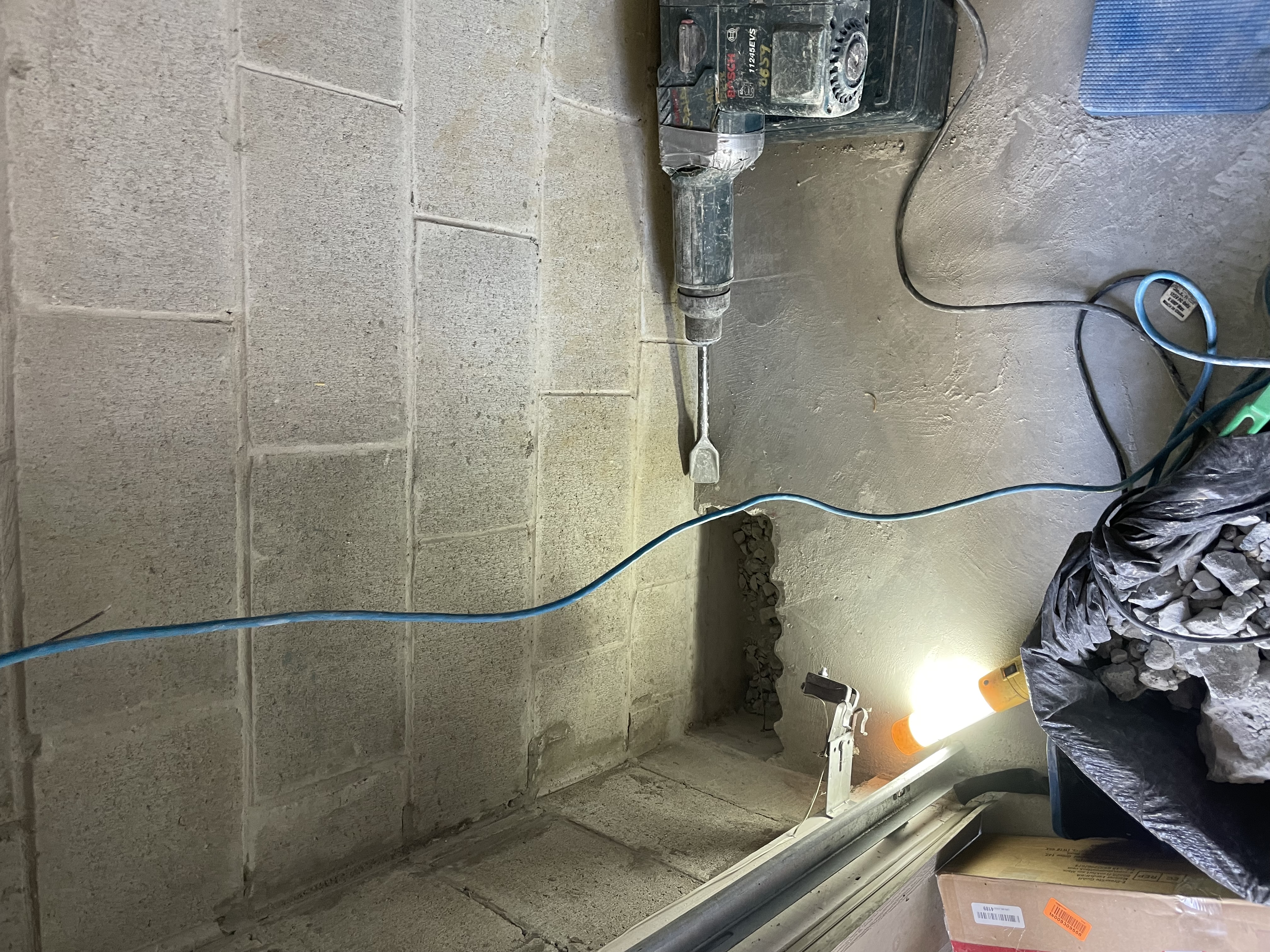

We are using a 6 port header and plan to install it just inside the Garage on the wall and run 2 pipes (hot and cold) back to the gas boiler. In order to have the PVC heating loops enter the garage I needed to “chip out” the concrete floor in the corner of the garage and then tunnel through the block under the front of the garage so as not to have to cut the threshold.


Project
Machines ready to go.

The first step was to remove the pavers from the front landing and remove the steps.

Used the smaller machine to widen the hole in order to make room for the 11 penetrations for the hot and cold lines and the sensor lines.


Decided to use the bricks from the front landing to expand the back deck landing.


Day 1
The day has come to start construction. The first step is to remove the front steps and scrap a load of gravel off the driveway.



Day 2
Time to start to reinstall the steps with heater pipes underneath. The key is to align the first step and have a conduit in place to receive the return line back to the header. For the steps, we decided to forego the styrofoam base and instead just pack the dirt and then cover the pipes with about 2 inches of HPB.


With the first step aligned and levelled, the remaining steps should be quick to put into place and we also can bury some extra conduits that will allow us to install a water line to the garden and low voltage LED lights for the retaining walls.
Day 3
The 11 penetrations have now been “tweaked” and 11 sleeves are now installed.


Next it was time to install 3 conduits - 2 (water and power) to the main upper garden and one to the small side garden for power.
For the main “upper” garden I had to dig a 30 inch deep hole behind the wall to feed the conduits through.


These conduits are installed 5 inches below the step to ensure that they are deep enough to not get in the way of the heating pipes.

The 2 conduits are installed and the step is “prepped” for levelling and to have the heating loops installed.


The electrical conduit is also “roughed” in to the small “side” garden. The blocks at the top of this wall and the coping were sinking and need to be levelled and reinstalled. But for now the conduit is buried below out of the way.

Day 4
With all the pentrations in place as well as the conduits, it is time to focus on re-installing the steps, laying the pucks and running the 3/4" loops.

Driveway packed and ready for Pucks

Pucks and 3/4" loops installed
'
Day 5
Time to pour concrete

Hand "Pailing" the Steps


Mike, Wally (aka Walter) and Jimmy Spreading Concrete
Johnny Inspecting the Final Pour




Day 6
With the concrete dried, it is time to level the driveway with HPB and lay 5 skids of 80 mil stone.





Day 7
Final day for outside work has us drilling/cutting the holes for the waterbox and the snow sensor and thermostat probe. Fixing the retaining wall copings and applying the Polymeric sand,
Rinsing the Polymeric sand

Final product


Header

More updates to come....
